What a Product Roadmap Is: Commitments and Uncertainty

Artyom Sklyarov··7 min read

A product roadmap explains which problems a team intends to address, in what order, and with what level of commitment. Near-term work can be specific; uncertain later work should be marked as such. A feature list, stakeholder wishlist or distant schedule becomes misleading when it hides those differences.

Now, Next, Later is one useful format, not the only valid roadmap. Contractual dates, dependencies and regulated releases may need a more explicit schedule. The product strategy should explain why an item belongs on either kind of plan.

Key Takeaways

  • Show why work matters and how firm its commitment is.
  • Dates and dependencies can be necessary; unsupported certainty is the problem.
  • Now, Next, Later is one format for uncertain work.
  • Review when evidence changes, with a cadence suited to the team.

What a roadmap is for

A roadmap helps a team explain priorities and coordinate commitments with others. It should distinguish an intention to investigate a problem from an agreed delivery obligation. Those purposes can coexist when the level of certainty is visible.

It is not the strategy. Our product strategy post draws the line: strategy answers why this sequence and not another; the roadmap is the sequence. A roadmap without a strategy behind it is a list of things people asked for, and nobody can say which item to drop when time runs short.

It is also different from a backlog. A backlog holds work or options at a finer level of detail; the roadmap communicates selected priorities and direction. Teams may prune both.

Three failure modes to check

1. The feature list with dates

SSO on March 3, Dashboard v2 on March 17, an integration in April: a dated feature plan can be useful when scope and dependencies support those commitments. It becomes misleading when provisional guesses are presented as promises or when the reason for building each feature is absent.

Marty Cagan argues for testing and discarding weak ideas through product discovery. That is practitioner advice, not a measured universal failure rate. A feature commitment made before discovery can lock a team into a solution whose value is still uncertain. Record the question and the evidence needed before turning it into a delivery promise.

2. The stakeholder wishlist

Sales wants enterprise SSO. The CEO wants AI summaries. The biggest client wants exports, support wants search fixed, the board wants a mobile app. Line them up, estimate each, and you have a roadmap that records who asked rather than what the product is for.

A request list needs a decision method when priorities conflict. Translate requests into the underlying problems, then compare evidence, impact, obligations and dependencies. Stakeholder input remains useful; it needs context rather than automatic acceptance or rejection.

3. The twelve-month Gantt chart

A year-long Gantt chart can expose dependencies and dates. The failure is presenting month nine with the same confidence as next week when the evidence does not support that certainty.

Mark assumptions, confidence, decision dates and contractual constraints. Keep a schedule where coordination requires one, and revise it when conditions change. A column roadmap can hide the same uncertainty if its items are presented as unconditional commitments.

A format for uncertain work: Now, Next, Later

For exploratory product work, three horizons can make uncertainty visible. Keep real external deadlines explicit rather than hiding them in a column.

Now is what the team is committed to, stated as a problem and an outcome, not a feature: cut onboarding drop-off from 60 to 40 percent. The team chooses how.

Next is what is likely, less specific, still a problem: win teams, not just individual users.

Later is what you are exploring and not yet committed to: a mobile app, if usage says so.

These example items are illustrative, not targets for every company. Include an owner, the evidence behind the priority and the condition for revisiting it. “Later” should not quietly become a promise to stakeholders.

An outcome-oriented item can leave room to test several solutions. A legal or contractual requirement may instead specify a particular capability and date. Record both the obligation and the remaining delivery risks.

Some teams plan in short cycles; others coordinate longer commitments across organizations. A practice from one company is not evidence that every startup needs the same planning horizon or investor presentation.

Compare the tool with the roadmap you need

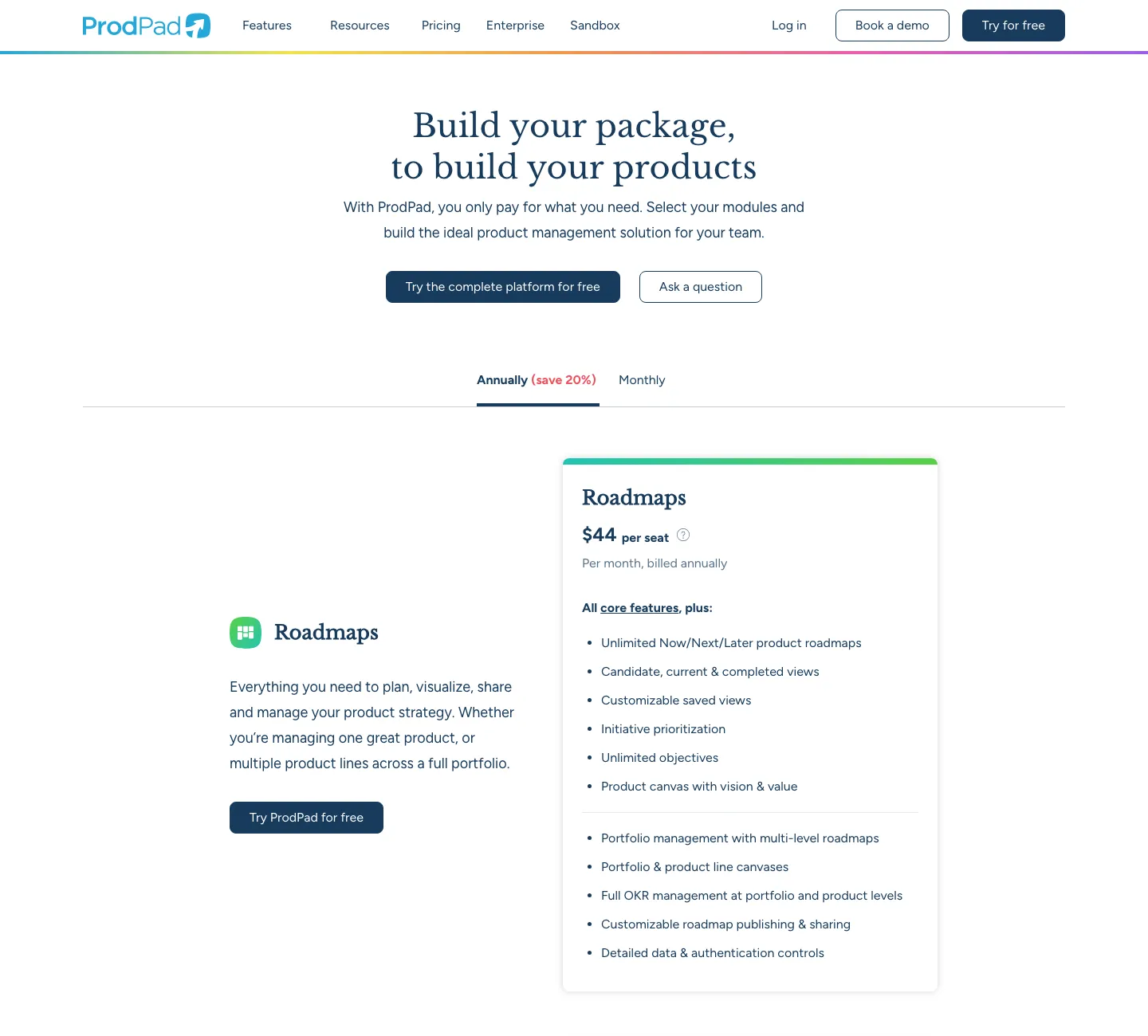

ProdPad's pricing page on 26 September 2026: the Roadmaps module at 44 dollars per seat per month billed annually, with unlimited Now, Next, Later roadmaps
ProdPad's pricing page on 26 September 2026: the Roadmaps module at 44 dollars per seat per month billed annually, with unlimited Now, Next, Later roadmaps

The retained ProdPad capture shows its Roadmaps module at $44 per seat per month billed annually on 26 September 2026. That is a historical advertised offer, not a current quote or the cost of every module. For tools already in your workflow, check the current Linear and Notion plan terms before adding another subscription.

A document or board can be enough for a small roadmap. Test a dedicated product with the same example before buying:

RequirementWhat to demonstrate
Different commitmentsA confirmed release date alongside an investigation with no promised delivery date
DependenciesA blocked item and the decision or work it depends on
Different audiencesAn internal planning view and the information external stakeholders may see
EvidenceThe customer problem, supporting research and reason for a priority change
Commercial scopePaid editors, reviewers, guests, minimum seats and the billing commitment
Leaving the toolAn export that preserves the information the team needs

Compare the total committed fee for the people who will use it. A tool can make the plan easier to share; it cannot decide which commitments the team can responsibly make.

How to write one this week

  1. Start from the strategy. If you cannot say who the product is for and what you will not build, write that first. The roadmap is downstream of it.
  2. Write Now as problems with outcomes. Start with a small set. Name the evidence or measure that would show progress; record a specific capability or date when an obligation requires it.
  3. Keep Next short and Later honest. Later is a list of options, not a queue. Say so on the page.
  4. Label what a date means. Distinguish an external obligation, an estimate and a review date. For uncertain work, a horizon can be more useful than a delivery date.
  5. Choose a review cadence and exception rule. A monthly review may be useful, with earlier review for consequential evidence, dependency changes or obligations. Do not wait for a calendar ritual to correct a known false assumption.
  6. Test it. Could someone who joined yesterday read it and say why each item is there, and what would make you drop it? If not, it is a to-do list with a calendar.

Where this comes from

The roadmap needs an accountable owner who can coordinate product direction and delivery. In a small startup that may be a founder; other teams assign a product lead. Our Fractional CPO offer starts at $15,000 a month, with direction agreed in writing in the first week. Our Product Sprint is a separate $9,000, five-day engagement for an agreed bounded scope, not a promise to complete any item labeled Now. If you are still deciding what the first item should be, start with what product strategy actually is.
